UNIS WHAT WE DO MODULARIZATION TRENDS IN EPC PROJECTS

MODULARIZATION TRENDS IN EPC PROJECTS

For more than 30 years, UNIS has been designing and supplying refining equipment for the oil and gas refining, chemical and power industries worldwide.

UNIS can provide the supply of many types of processing and refining units, modular or conventionally built, from initial concept through to commissioning, start-up and operational training.

With our acquired experience and capabilities in the field of modular design and construction, UNIS can design and supply modular systems that can be assembled on a mounting frame with dimensions suitable for transport on a truck and easily transported to remote locations anywhere in the world.

Modularization may be considered for the following main reasons and advantages:
  • less labor in the field, particularly where construction labor is limited
  • final assembly costs on site can be significantly minimised at a destination with poorly developed or limited infrastructure
  • remote site access and severe site weather constraints
  • desire to minimize field time
  • reduction of site waste
  • fewer jobsite environmental impacts
  • reduced requirements for onsite materials storage
  • increased worker safety through lower exposure to field hazards
  • improved schedule by parallel execution of construction tasks
  • permitting and civil work can proceed in parallel with shop fabrication.

PROCESSES SUITABLE FOR MODULARIZATION

Modularization can be applied for the following processes, but not limited:

  • Crude distillation unit (CDU)
  • Vacuum distillation unit (VDU)
  • Stabilizer unit
  • Asphalt blowing unit
  • Naphtha hydrotreater unit (NHT)
  • Diesel hydrotreater unit (DHT)
  • Catalytic reformer unit (CRU)
  • Isomerization unit
  • Hydrocracking unit

Note: capacity limitations due to equipment sizing must be taken into account.

DESCRIPTION OF TECHNICAL SOLUTION

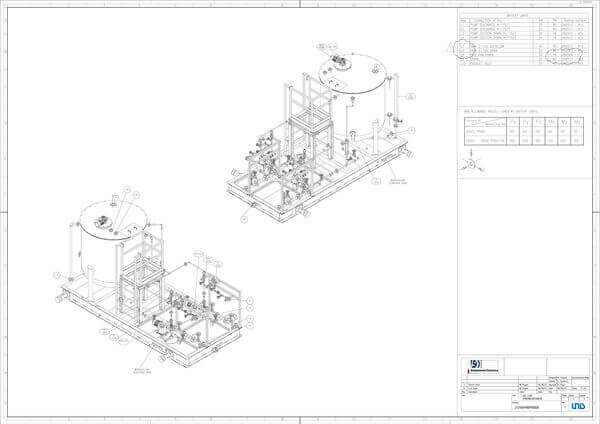

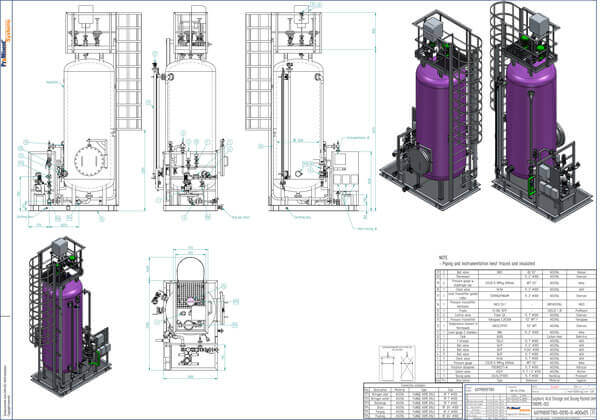

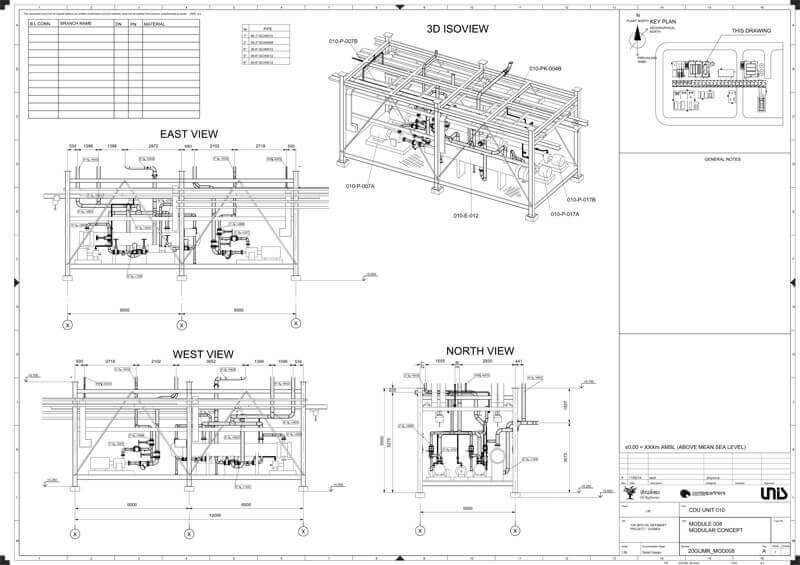

The Modules are supplied with the maximum possible scope of pre-assembly i.e. equipment (pumps, heat exchangers, vessels, etc.), piping, instrumentation, valves, painting, insulation, electrical and instrumentation equipment with cables connected to the junction boxes (see Skid Arrangement Drawing Modular Construction Example).

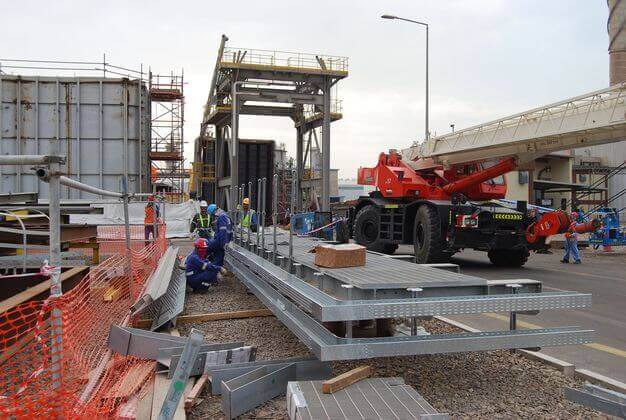

Generally modular concept is considered in modules suitable for transportation on trucks, dimensions 20 x 5,5 x 5,5 m, weight up to 50t).

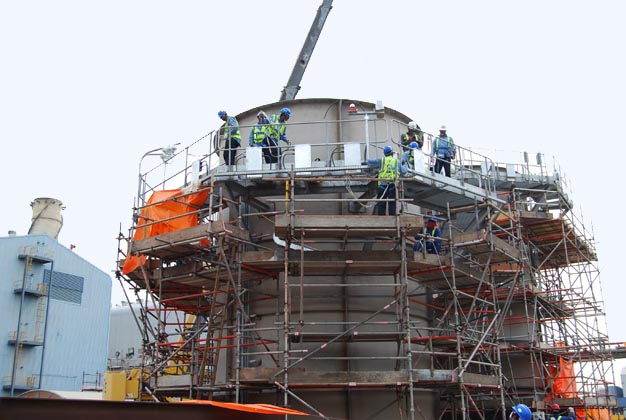

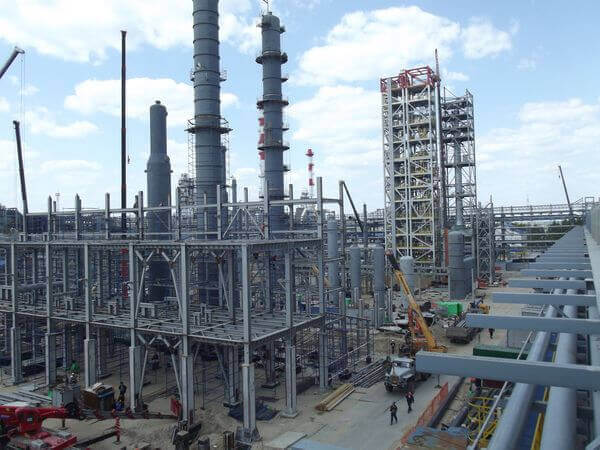

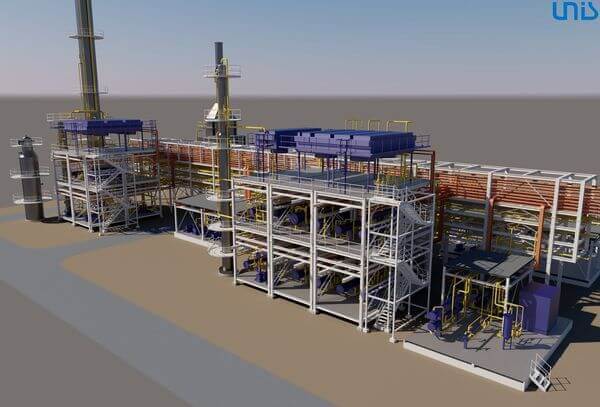

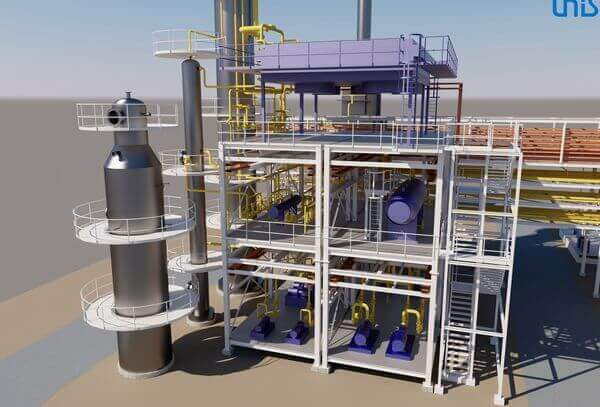

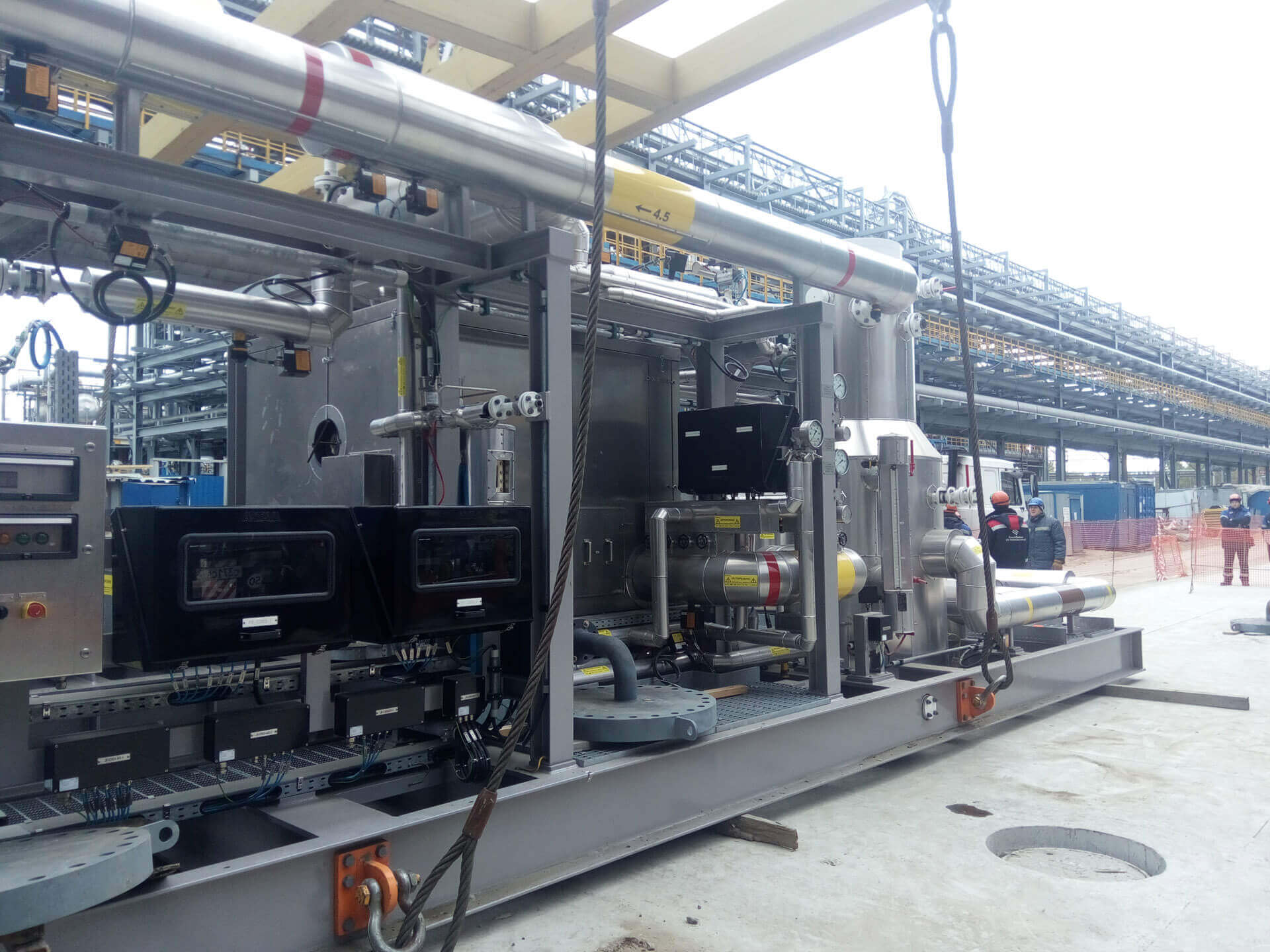

Modular unit

Main piperack pre-assembly

The main piperack structure steel as shown on General Layout Example, split into the modules, will be pre-assembled per adjoining modules at Yard. The lack of improper alignment of structural steel of the different modules will be avoided. The piping supports will be installed, aligned and levelled at Yard inside of the modules. Each pipe positioned inside of the individual module will be:
  • Cut (if necessary), welded (welds to be positioned outside of the supports), ends will be bevelled for welding on Site, the pipe will be NDT tested (all welds made at Yard) and blind. The weldolet may be used for the pipe size up to 1-1/2”. Each piece of pipe will be marked to be clearly identified on Site.
  • The drain (if any) will be prefabricated, pre-assembled and tested at Yard and supplied to Site.
  • The auxiliary equipment installed on the piperack (telecommunication system) will be installed in position, cable trays will be measured and cut in the required lengths, cables will be pooled, marked, terminated and tested. For the transport the cables that run between modules will be disconnected and coiled up. At Site they will be pooled, connected and tested.
  • For the transports the parts that may be damaged during the transports will be marked and disassembled. The bottom (support and cross beams) parts of the piperack structure will be disassembled into 2D arrangement and packed.
Modular unit

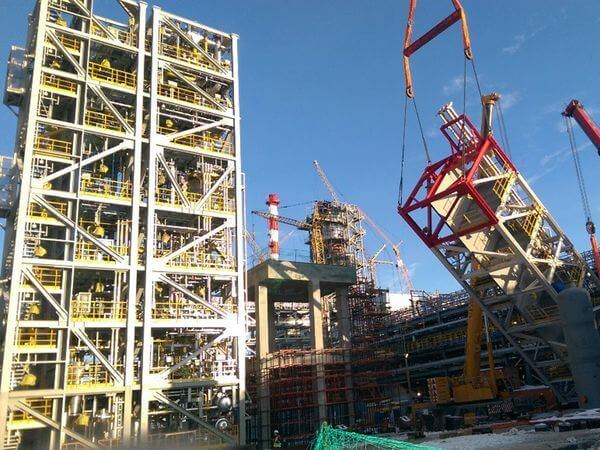

According to UNIS experience this arrangement will optimize the transportation expenses and will assure smooth erection at Site.

Modules pre-assembly

The following procedure is applied to Structures pre-assembly at Yard:
  • The platform levelling has to be done as first step (e.g. framed structure)

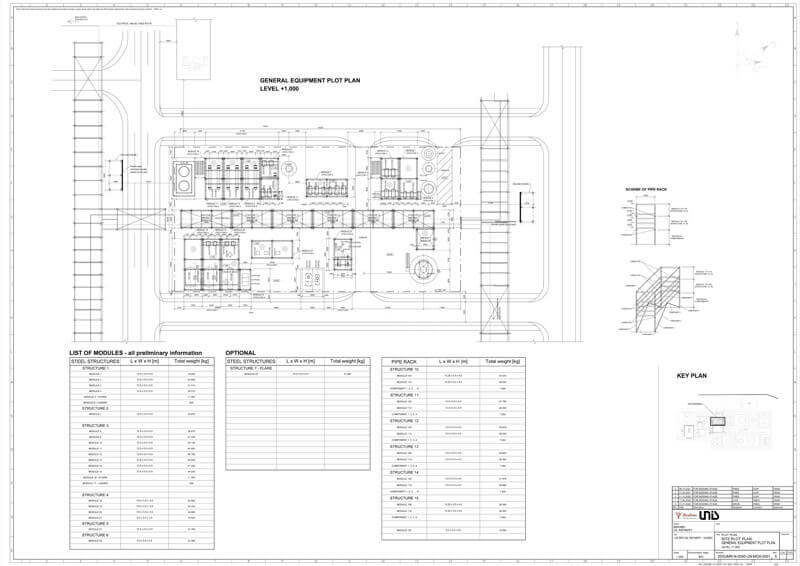

  • The structure steel of all six modules will be assembled into the Structure and structure steel completeness test will be performed.
  • The main process equipment will be installed into the modules (anchored).
  • The piping installation inside of the modules and interconnection piping between modules will be preassembled and installed (flanged or welded connection will be used as per pipe class). The pipe connection to mechanical equipment shall be flanged.
  • After the mechanical completion the pressure test will be done. The inline instruments for pressure test will replaced with spool pieces. After the successful pressure test inline instruments will be installed.
  • If any of the line running between modules will not be possible to installed at Yard the line will be prefabricated and fit test will be done. Extra-lengths will be provided at piping to do golden weld at Site. The pipe spools will be hydraulically tested at Yard, dried, blind and packed for transport. Golden weld and 100% NDT will be done at Site.
  • After the pressure test the other works may start (instrumentation, electrical, insulation, …).
  • The instruments (including telecommunication, FDS/GDS systems), junction boxes and the cable trays will be installed. Cables will be pooled and terminated. The insulation and continuity test will be done. The instruments and cables will be marked as per design documentation.
  • If any of the instrument cables will run between the modules these will be disconnected and coil-up at one module. After the Structure assembly at site these cables will be pooled, connected and tested.
  • The lighting, lighting junction boxes and sockets will be installed. The cable trays will be placed into the position, cable will be pooled connected and tested. The lighting test will be done after the testing.
  • Electrical motors rotation test will be done at Yard.
  • The intermittent inspection with the Employer will be done during the prefabrication.
  • After the mechanical completion of the all preassembly works the Final inspection with the Employer will be done.
  • After the successful final inspection each module will be provided with the inspection book (all test, inspections done at Yard).

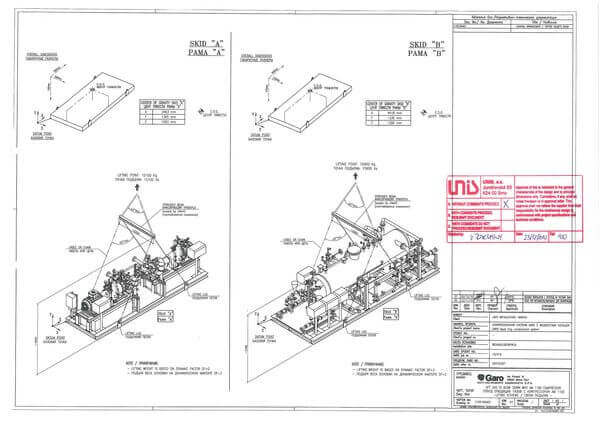

  • The Structures will be disassembled into the modules suitable for transport. The interconnection piping between modules will be marked, blind and packed for transport. Any equipment that could be damaged by the transport (e.g. analysers) will disassembled, marked and packed for transport.
  • The auxiliary material for lifting and transport will be provided (e.g. lifting lugs, lifting beams, temporary beams and supports).
The equipment that will not be possible to install within the modules will be supplied as a Loose Equipment, for example: flares, crude charge pumps, fired heater, columns, underground slop vessels (including pumps), air cooled heat exchangers, interconnection piping between the modules and loose equipment, firefighting equipment as hydrants, secondary steel structures, platforms with handrails (for columns), stairs, etc.
The loose piping will be prefabricated into the spools (the limitation of spools by the limitation of the transport container dimension). The prefabricated spools will be tested as requested by the applicable code. The flange spools will be supplied hydraulically tested. Supports for loose piping will be supplied prefabricated as per design documentation.
The equipment, piping insulation and labelling inside the battery limits of the Modules will be installed at Yard. The insulation clips for loose items should be installed, if there will be no limitation by the transportation condition (e.g. supports for transport).
